On This Day · 20 years ago

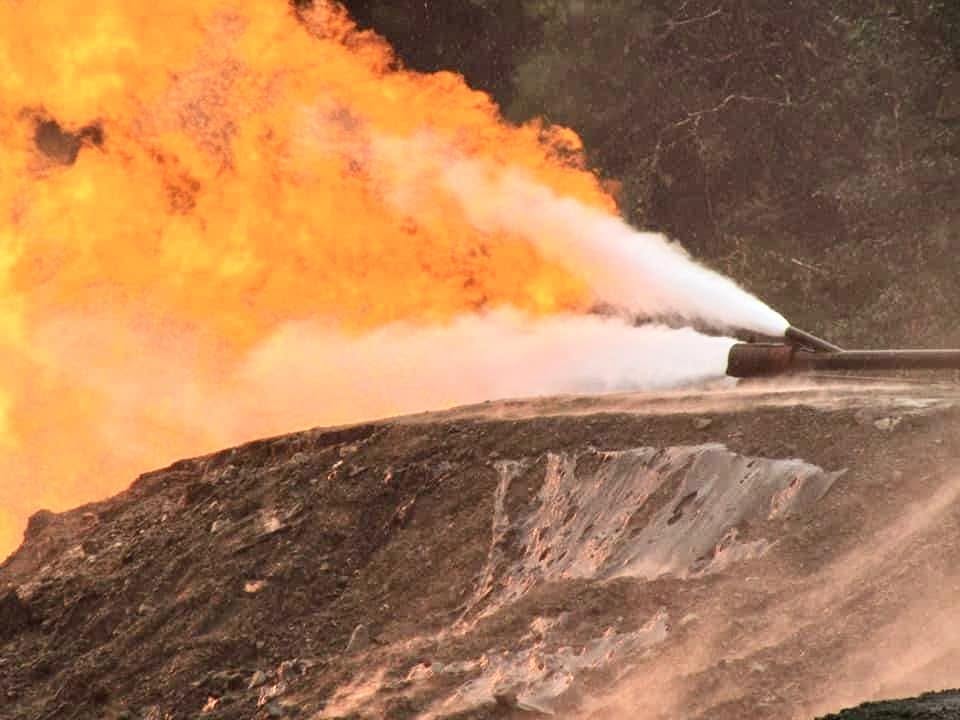

Elk-1: a test result worth remembering
Twenty years ago today, Upstream reported encouraging results from InterOil’s Elk-1 gas discovery in Papua New Guinea: a gas flow of 21.7 million cubic feet per day, accompanied by condensate.[1] The Elk-1 well later flowed at a record rate of 102 million cubic feet of gas per day, placing it as the highest gas well flow rate in Papua New Guinea’s history.[6]
20
Years ago
The report The road to Elk-1 Its place in the story What followed Sources
01 / THE REPORT
A promising result from Elk-1
The 25 October report described gas flowing through a small choke from a highly permeable, fractured reservoir, with condensate measuring 46° API. InterOil was preparing the well for a long-term production completion, then expected to take another two to three weeks.[1]

“We are very encouraged by these early test results”
Phil Mulacek, then InterOil’s chief executive
Quoted by Upstream, 25 October 2006.[1]
An original historical summary of the published report, not a reproduction of the publisher’s article. Read the contemporary report ↗
A note about the anniversary
This page remembers the report published on 25 October 2006. The October testing occurred earlier: a GLJ assessment records a sample collected during DST #2 on 10 October, and the same maximum flow result appeared in Oil & Gas Journal on 20 October. The available records do not establish the exact day of the maximum flow step.[1] [2] [5]
02 / THE CHRONOLOGY
The road to that October headline
Behind that October headline lay an exploration license, seismic surveys, a new rig and months of demanding well operations. This is the story that led to the report.
7 March 2003
The exploration ground is secured
PPL 238, the license containing Elk-1, is granted to InterOil.[3]
2004
Seismic work investigates the prospects
InterOil completes seismic work across the Puri, Elk and Moose prospects.[3]
25 February 2005
Funding backs an eight-well programme
An amended participation agreement provides US$125 million for eight exploration wells in Papua New Guinea.[3]
October 2005
A rig built for the task
InterOil acquires its purpose-built, helicopter-portable Rig #2, capable of drilling to 13,500 feet.[4]
19 February 2006
Elk-1 begins drilling
The well is spudded in the Eastern Papua Basin, targeting fractured limestone on the Elk structure.[4]
May 2006
A parallel gas-development ambition
InterOil signs a memorandum of understanding with Papua New Guinea’s government concerning domestic natural-gas processing, ahead of a definitive project agreement.[4]
11 June 2006
High-pressure gas changes the programme
Gas is encountered at 5,543 feet. The well is shut in while additional well-control equipment is mobilised.[3]
June 2006
The first drill-stem test
The first test flowed gas at a rate of 7.1 million cubic feet per day. A subsequent, deeper test significantly surpassed this milestone, recording a maximum flow rate of 21.7 million cubic feet per day.[2]
15 September 2006
Drilling resumes
After well-control work and rig reconfiguration, drilling resumes using managed-pressure drilling.[3]
7 October 2006
The well reaches total depth
InterOil’s annual filing records total depth at 6,504 feet.[3]
10 October 2006
A dated record from the second test
A later GLJ technical report identifies a gas sample collected during Elk-1’s second drill-stem test on this date.[5]
20 October 2006
The October result is already in print
Oil & Gas Journal reports a maximum gas rate of 21.7 million cubic feet per day from the second test.[2]
25 October 2006
This anniversary
The report remembered today
Upstream publishes its account of Elk-1’s encouraging test results. This is the publication anniversary marked by this page.[1] Elk-1 was later tested and flowed at a record rate of 102 million cubic feet of gas per day and 510 barrels of condensate a day. [6]
Dates are shown only as precisely as the cited record supports. A month-only entry does not imply a verified day within that month.
03 / THE INTEROIL STORY
Why this moment matters
Seen in the wider InterOil story, Elk-1 belongs to the period when a business with refining and fuel-distribution operations was pursuing the scale of its upstream opportunity. By 2006, its refinery was operating and the company was also exploring a future in natural-gas processing.[4]
The importance of the October result was therefore not simply the number in the headline. It gave the exploration story a tangible point of reference: a tested well, followed by completion and appraisal. Later technical assessment placed Elk-1 at over 102 million standard cubic feet of gas per day, creating the beginning of the Elk discovery and the wider Elk–Antelope exploration story.[3] [4] [5]
Those were encouraging test results, not a declaration that commercial production had begun. The distinction matters: testing a well, estimating a resource and establishing commercial reserves are different milestones. InterOil’s later filing still described the need for further drilling and development before proved reserves could be assigned.[4]
04 / WHAT FOLLOWED
The next chapter was appraisal
That is the moment worth remembering: not the end of the work, but a result that made the next questions worth pursuing.
Remembering the people behind the record
The numbers tell only part of the Elk-1 story. Behind it were the people who drilled, tested and supported the well.

Reading the numbers
The headline rate is a test result, not a forecast of sustained field production. Subsequent appraisal and development were separate stages.[4] The 21.7 million standard cubic feet per day was a drill stem test rate; a later flow test reached 102 million cubic feet per day.[6]
From the archive
This post draws on Upstream’s report on 25 October 2006, later InterOil filings and a third-party technical assessment.
The historical record
Sources & further reading
1
Upstream · 2006-10-25. Published 25 October 2006, 03:39 GMT.
2
More work set at Papuan gas-condensate find
Oil & Gas Journal · 2006-10-20. Article dated 20 October 2006; paragraphs describing DST 1 and DST 2.
3
Annual Information Form — year ended 31 December 2006
InterOil Corporation / SEC EDGAR. Printed pp. 10, 15–16, 40 and 42: 2004 history; PPL 238; 2006 exploration; material contracts.
4
Annual Information Form — year ended 31 December 2007
InterOil Corporation / SEC EDGAR · 2008-03-28. Printed pp. 10–12: upstream history, refinery and liquefaction.
5
Elk / Antelope resource assessment — effective 31 December 2009
GLJ Petroleum Consultants (archived copy on Scribd). Executive summary; Initial Reservoir Conditions and Fluid Properties, printed p. 28 (immediately before the p. 29 marker in the text extraction).
Third-party-hosted archival copy of the GLJ report.
6
InterOil’s gas well blasts record
Hart Energy · States that Elk-1 tested in 2006 at 102 million cubic feet of gas and 510 barrels of condensate per day.
